Energy

Reserve heat source 132 MW heating plant in Elektrociepłownia Stalowa Wola S.A.

Contract value: 55 mln PLN gross
Completion date: 15 months

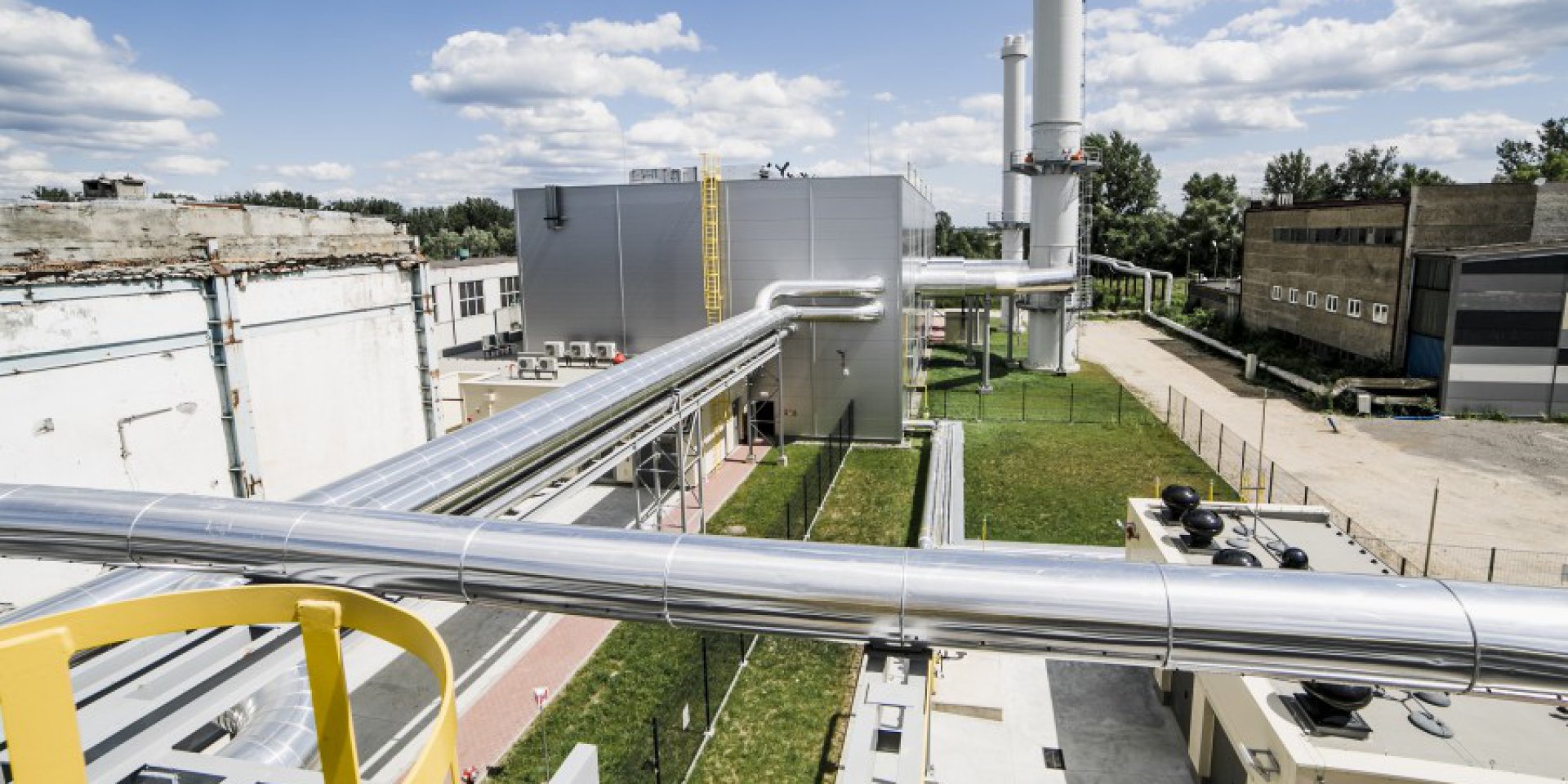

The reserve heating plant consists of three water boiler with a capacity of 36 MW each, one water boiler with a capacity of 12 MW and a steam boiler with a capacity of 15 t/h (capacity: 12 MWt). The total power of the plant is about 120 MWt, including a steam boiler - a 132 MWt.

The heating plant secures about 70% of the heat demand in the peak of the heating season. The recipients of the produced thermal energy are two independent heating systems and recipients of technological steam.

Contract value: PLN 55 million gross
Date of signing the contract: 28.08.2018
Implementation deadline: 15 months
Payment deadline: within 30 days from the date of delivery of invoices to the Ordering Party
The warranty period: 24 months - Basic Period, and 60 months - Extended Period.
Due performance security for: 10% of the contract value.
